Typical Schedule

The section walks you through the typical schedule of a particular release from start to finish.

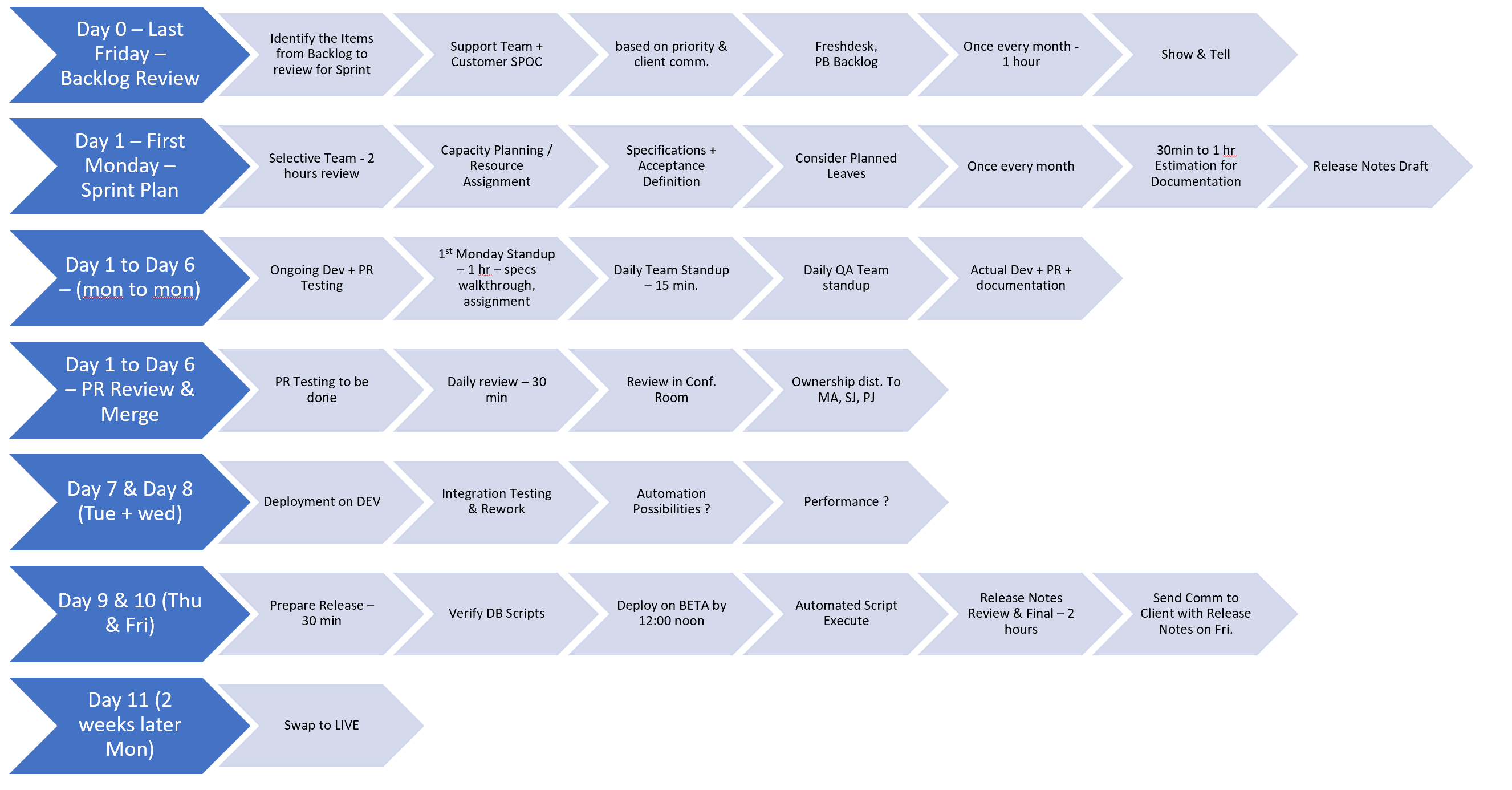

Typical Schedule

Notes

  1. The schedule is designed for supporting 2 releases per month with each release spanning approximately 2 weeks.
  2. There could be a few days of buffer between the releases to account for any unforeseen delays.
  3. The schedule outlines the all the steps from prioritization to planning to development to testing to release.
  4. We've also included typical duration for each stage and each task.
